Office Furniture Installation: Labour and Site Questions

2026/9/17 17:06:47


Installation is where a well-priced office furniture contract becomes unprofitable, and where dealers get caught by site conditions they never saw at quotation stage. These five questions cover how installation labour is estimated, which site conditions move the number, flat-packed versus assembled furniture, packaging removal, and how to handle defects discovered during installation.

Q1. How is installation labour estimated for an office fit-out?

Most installers price from a work-item rate multiplied by quantity, then add site-specific allowances. The rate covers unpacking, assembly, positioning and levelling per desk, chair or storage unit, and it differs sharply between simple task chairs and height-adjustable benching with cable management. To that base, add travel, a lift or hoist, out-of-hours working, and supervision. Ask for the estimate as a schedule of rates rather than a single lump sum so you can see which items drive cost.

Q2. What site conditions most affect the labour estimate?

Access is the biggest variable. A building with a service lift, a loading dock and wide doorways costs far less to fit out than a listed building reached by stairs with a narrow entrance. Other cost drivers include whether the floor is level and finished, whether power is live for testing height-adjustable desks, whether work is permitted during business hours, and how far the installation crew must carry goods from the drop point.

Q3. Does flat-packed furniture cost more to install than assembled?

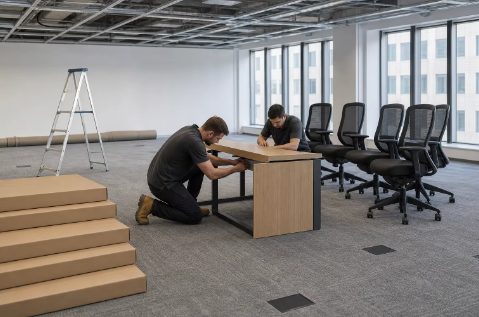

Almost always, and the gap is easy to underestimate. Flat-packed items arrive with a hardware pack and instructions, so the crew spends time on assembly that would otherwise be spent only on positioning. A single desk may take a fraction of an hour to position but an hour or more to build, and error rates rise when a large floor is assembled from many identical cartons. The trade-off is worth costing per project, not per container.

Q4. Who removes packaging and waste from site?

Whoever is named in the contract, and it should be named explicitly. Installation quotations typically include unpacking but not waste removal, so cardboard, foam and shrink wrap are left on site unless removal is priced in. Recycling rules differ by city, and some buildings restrict when waste can be moved through service corridors. Agree the volume expected, the removal route and the cost before work starts, and photograph the site after handover.

Q5. How should defects found during installation be handled?

Record them before they are buried. Photograph the damaged part in its carton where possible, note the model code and quantity, and list it on a single snagging document signed by the site contact. Report within the claim window the supplier specified, and keep the packaging of damaged items until the claim is settled. Separately agree who funds the return leg and the replacement freight, and whether the installer will be paid to revisit site for refitting.

Bottom line: Installation cost is set by access, assembly time and who clears the waste — three things worth writing into the contract before the crew arrives.

Hangzhou Fangai Trading Co., Ltd.
Tel: +86 18268846913
Email: market@hzfgfurniture.com
: Room 808, 8th Floor, Building B, No. 530, No. 20 Street, Baiyang Subdistrict, Qiantang District, Hangzhou City, Zhejiang Province, China
  • Whatsapp
  • Instagram
  • Facebook

Copyright www.hzfgfurniture.com. All Rights Reserved.  浙ICP备2026006019号
